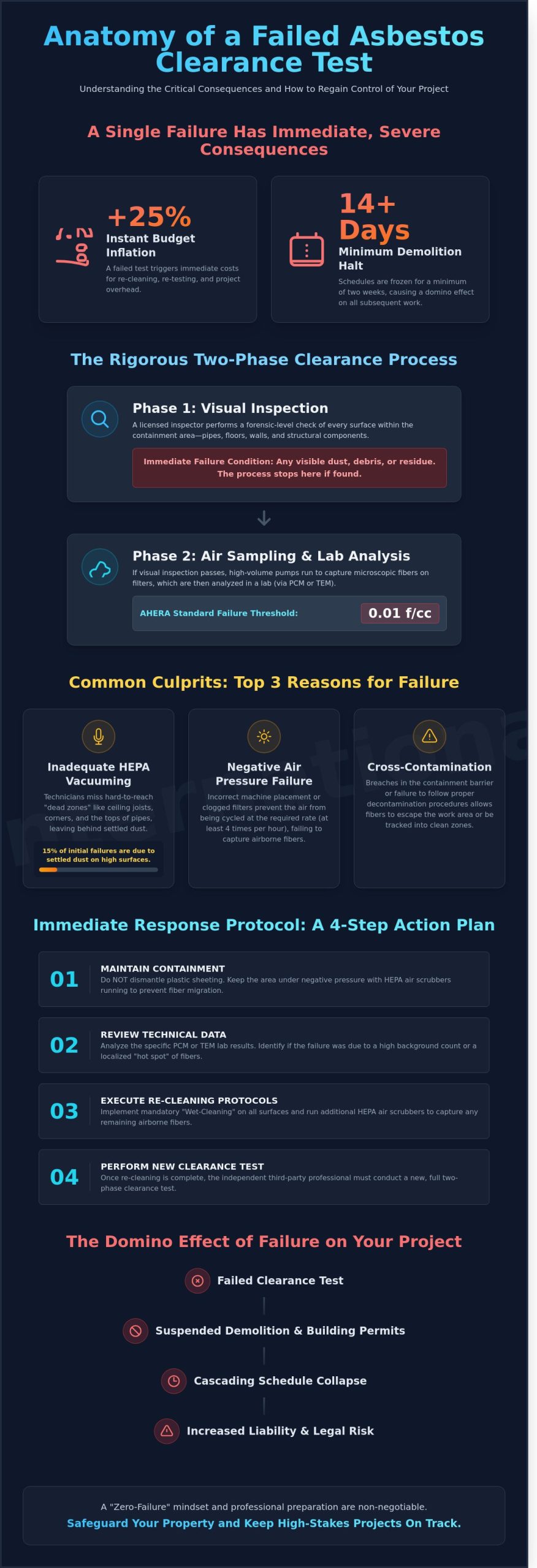

What Happens If Asbestos Abatement Fails a Clearance Test? A 2026 Guide

A single failed clearance test can instantly inflate your project budget by 25% and halt demolition schedules for a minimum of 14 days. This isn’t…

What Happens If Asbestos Abatement Fails a Clearance Test? A 2026 Guide

A single failed clearance test can instantly inflate your project budget by 25% and halt demolition schedules for a minimum of 14 days. This isn’t just a minor administrative setback; it’s a critical indicator that your containment strategy or cleaning protocol has failed to meet the rigorous safety standards required for 2026. Understanding exactly what happens if asbestos abatement fails clearance test is essential for property owners who need to regain control over their site’s safety and legal standing. You’ve likely worked hard to keep your facility’s renovation on track, and the news of a failed air sample can feel like a devastating blow to both your timeline and your liability profile.

We’ll show you exactly how to navigate this crisis by identifying the technical root causes of failure and implementing the corrective actions needed to ensure your building is 100% safe for re-occupancy. This guide outlines the mandatory re-cleaning procedures and the engineering adjustments required to pass the next round of testing with certainty. We’ll examine the top reasons for failure, such as inadequate HEPA filtration or improper wetting techniques, and detail the specific steps required to maintain your structural demolition timelines without compromising worker health.

Key Takeaways

  • Understand the rigorous two-phase evaluation process required to prove a site is safe for reoccupation and why professional standards are non-negotiable.
  • Discover exactly what happens if asbestos abatement fails clearance test, including the immediate protocols for maintaining containment and analyzing technical failure data.
  • Learn about the mandatory “Wet-Cleaning” protocols and advanced HEPA filtration techniques used to remediate a site and ensure regulatory compliance.
  • Identify the significant project risks associated with failure, such as the suspension of demolition permits and the resulting domino effect on construction schedules.
  • Gain insight into how a “zero-failure” mindset and professional preparation can safeguard your property and keep high-stakes projects on track.

Understanding the Asbestos Clearance Test and Common Failure Points

A final clearance test is a mandatory two-phase evaluation designed to prove a remediation site is safe for reoccupation. This process doesn’t rely on guesswork; it follows a strict technical protocol to ensure no hazardous materials remain. In the context of the 2026 safety standards, these tests serve as the final gatekeeper between a hazardous work zone and a functional living or working space. While professional abatement teams utilize specialized engineering controls, DIY attempts frequently fall short of these rigorous benchmarks due to a lack of industrial-grade equipment and containment expertise.

Regulatory frameworks established by the EPA and OSHA mandate that clearance testing must be performed by an independent third-party professional. This requirement eliminates conflicts of interest, ensuring the contractor who performed the removal isn’t the one certifying the area as safe. According to current federal guidelines, a clearance failure constitutes a breach of either visual cleanliness or air fiber concentration limits.

Understanding what happens if asbestos abatement fails clearance test protocols begins with recognizing that safety is measured at the microscopic level. Even if a room appears pristine to the naked eye, the presence of sub-visible fibers can trigger a failure, requiring immediate corrective action and re-cleaning of the entire containment area.

Visual Inspection vs. Air Sampling Failures

The visual inspection phase is the first hurdle. A licensed inspector examines every inch of the containment area, looking for dust, debris, or residue on pipes, floorboards, and structural components. If any visible dust is found, the test ends immediately as a failure. The site can’t proceed to air sampling until it passes this forensic-level cleaning check.

The air sampling phase involves using high-volume pumps to capture microscopic fibers on a filter for laboratory analysis. Technicians typically use Phase Contrast Microscopy (PCM) or Transmission Electron Microscopy (TEM) to count fibers. A site often looks clean but fails the microscopic count because fibers remain buoyant in the air for 48 to 72 hours if not properly managed. Under AHERA standards, the limit is generally set at 0.01 fibers per cubic centimeter (f/cc) of air.

Common Culprits: Dust, Debris, and Microscopic Fibers

Failures are rarely the result of a single mistake but rather a breakdown in technical execution. Most issues stem from three specific areas:

  • Inadequate HEPA Vacuuming: Technicians often miss hard-to-reach corners, ceiling joists, or the tops of door frames. These “dead zones” collect settled dust that becomes airborne once the air pumps start.
  • Negative Air Pressure Failures: Negative air machines must cycle the room’s air volume at least four times per hour. If the machines are positioned incorrectly or filters are clogged, they won’t effectively scrub the environment.
  • Cross-Contamination: This occurs when workers move between the “hot zone” and clean areas without following proper decontamination procedures, or when the containment barrier itself has a breach.

When analyzing what happens if asbestos abatement fails clearance test, the data shows that 15% of initial tests fail due to settled dust on high surfaces. This statistic highlights why professional-grade execution is non-negotiable for site safety.

Immediate Steps to Take After a Failed Clearance Report

A failed clearance test requires immediate, disciplined action to prevent cross-contamination. When asking what happens if asbestos abatement fails clearance test, the response must follow a strict engineering protocol rather than a reactive one. The priority shifts from project completion to containment integrity and rigorous data analysis. You can’t treat a failure as a minor setback; it’s a technical non-conformance that demands a systematic reset of the site safety plan.

The 2026 protocol dictates a four-step immediate response sequence:

  • Step 1: Maintain the containment area. Don’t take down plastic sheeting or turn off HEPA-filtered air scrubbers. The enclosure must remain under negative pressure to prevent fiber migration.
  • Step 2: Review technical data. Analyze the specific PCM or TEM failure results with your industrial hygienist to identify the source of the contamination.
  • Step 3: Notify stakeholders. Issue a formal notice to general contractors, safety officers, and facility managers to adjust project timelines.
  • Step 4: Schedule re-cleaning. Arrange a mandatory deep-cleaning session with the abatement team, focusing on the specific areas identified in the report.

Keeping the Containment Secure

Breaching the containment barrier before a second successful test is a critical safety violation. If you open the area prematurely, you risk releasing microscopic fibers into clean zones, which could necessitate a full facility decontamination. Negative air machines must operate 24/7. Monitoring equipment should confirm a minimum pressure differential of -0.02 column inches of water. This ensures that any airborne fibers remain trapped within the HEPA filtration system. Access must be restricted to authorized hazardous material personnel who follow full decontamination procedures, as the site remains a high-risk environment until the final air sample passes the 0.01 f/cc threshold.

Reviewing the Industrial Hygienist’s Findings

Interpreting the data correctly is essential for a successful remediation. Your industrial hygienist will provide results based on Phase Contrast Microscopy (PCM) or Transmission Electron Microscopy (TEM). If a PCM test shows a fiber count above 0.01 fibers per cubic centimeter (f/cc), it indicates the presence of airborne particles that might be asbestos. TEM analysis provides more detail by identifying specific asbestos mineral types. Use these findings as a technical roadmap. A failure in one corner of a 5,000-square-foot floor suggests a localized cleaning error, while high counts across all samples indicate a systemic failure in the wet-stripping or HEPA-vacuuming process. This data-driven approach ensures that specialized solutions are applied exactly where the previous cleaning fell short.

The re-cleaning process isn’t just a second pass; it’s a targeted intervention. Understanding what happens if asbestos abatement fails clearance test allows project managers to maintain control over the site’s safety profile. By treating the failure as a data point for improvement, you ensure the final environment meets the highest safety standards required for re-occupancy.

What Happens If Asbestos Abatement Fails a Clearance Test? A 2026 Guide

The Remediation Process: How Contractors Fix a Failed Site

When a project fails a final air clearance, the contractor must immediately transition from a standard removal phase to a rigorous secondary remediation protocol. This phase isn’t a simple repeat of previous steps; it’s a specialized technical reset designed to capture microscopic particulates that escaped initial containment. Understanding what happens if asbestos abatement fails clearance test protocols involves looking at the mandatory 2026 safety standards that dictate how a site is restored to a compliant state.

The first rule of remediation is the absolute prohibition of dry sweeping. Dry methods are strictly forbidden in asbestos zones because they re-aerosolize settled fibers, making the environment more hazardous. Instead, technicians employ a “wet-cleaning” protocol using specialized surfactant solutions. These chemicals reduce the surface tension of water, allowing it to penetrate and weigh down microscopic fibers more effectively than standard water. To ensure complete decontamination, technicians must wait for the air to settle completely before re-cleaning so they can capture any falling fibers that have finally landed on horizontal surfaces.

Advanced HEPA filtration serves as the primary defense during this stage. Contractors must verify that every piece of equipment is serviced and that filters are seated with a perfect seal. Even a 1mm gap in a filter housing can allow thousands of fibers to bypass the system. Once the bulk of the cleaning is finished, teams apply lockdown encapsulants. These liquid polymers act as a permanent binding agent, sealing any remaining microscopic particles to the substrate and preventing them from ever becoming airborne again.

Recleaning and HEPA Vacuuming Protocols

Technicians focus their efforts on horizontal surfaces where fibers typically settle after active work stops. This involves surgical cleaning of window sills, door frames, and structural steel beams that often harbor dust. HVAC ducts receive extra attention to ensure no particles are trapped in the ventilation system. The team utilizes a “double-wipe” method: the first pass removes visible dust using a surfactant-soaked cloth, while the second pass with a fresh cloth ensures microscopic decontamination. Each cloth is disposed of as hazardous waste after a single use to prevent cross-contamination.

The Role of Negative Air Pressure and Air Scrubbing

Effective remediation relies on calculating the precise air changes per hour (ACH) for the specific volume of the containment. While standard projects may require 4 ACH, a failed site often necessitates 6 to 8 ACH to flush the environment. Technicians strategically position air scrubbers to eliminate “dead zones” in corners or behind structural pillars where air might stagnate. Before the second test begins, an independent professional must verify the integrity of the HEPA filters and confirm that the negative pressure monitors show a consistent draw of at least -0.02 inches of water gauge.

Regulatory and Project Implications of Failed Abatement

A failed clearance test creates an immediate regulatory wall. It’s not just a technicality; it’s a legal barrier that prevents the transition from environmental remediation to active construction. When a project fails to meet the 0.01 fibers per cubic centimeter (f/cc) threshold, the containment area remains a restricted hazardous zone. This status prevents the issuance of necessary demolition permits, as building departments require a passed certificate to close out the environmental phase of the project. Without this document, the entire structural workflow remains paralyzed.

Impact on Demolition Permits and Construction Timelines

The domino effect of a failed test can derail a 2026 project schedule within hours. Most commercial gutting or structural demolition timelines are exceptionally tight. A single failure necessitates additional cleaning, a 24-hour settling period, and a subsequent re-test. This process often adds 48 to 72 hours to the critical path. If you don’t coordinate with the building department immediately, you risk receiving stop-work orders that can last weeks. Transparency with regulatory agencies is the only way to maintain your project milestones without facing heavy penalties. It’s vital to update all stakeholders, including interior gutting crews, to prevent them from arriving at a contaminated site.

Responsibility for Re-testing Costs

Financial liability usually depends on the language within your initial contract. In standard industrial agreements, the abatement contractor absorbs the costs of re-cleaning and labor if they failed to meet the specified clearance criteria. However, the property owner often remains responsible for the independent industrial hygienist’s re-testing fees, which can range from $600 to $2,000 depending on the number of samples required. Utilizing hazardous material abatement experts who understand these protocols prevents these unexpected expenses. Professionals ensure the site is ready before the hygienist arrives, protecting the project’s bottom line.

Skipping a re-test is never an option for commercial properties. Under OSHA and EPA regulations, specifically 29 CFR 1926.1101, documented clearance is a mandatory safety requirement for re-occupancy. Violating these standards can result in federal fines exceeding $16,000 per violation day. Understanding what happens if asbestos abatement fails clearance test helps stakeholders prepare for these contingencies. It ensures that the transition to the next phase of construction remains legally sound and physically safe for all trades involved. Logical planning and high-tier execution are the only ways to avoid these structural delays.

Ensure your project stays on track with certified environmental oversight. Contact TSIAC International for professional abatement solutions.

Partnering with TSIAC International for High-Stakes Abatement

TSIAC International brings over 15 years of field-tested expertise to every remediation project. We operate with a “Zero-Failure” mindset because we understand the high stakes involved in hazardous material handling. Our preparation protocols consistently exceed standard regulatory requirements. We ensure that every containment zone is meticulously cleaned and inspected before a third-party consultant ever sets foot on the site. Knowing what happens if asbestos abatement fails clearance test, specifically the cascading delays and increased costs, drives our team to achieve compliance on the first attempt.

Why Experience Matters in Abatement

Success in this industry depends on recognizing the nuances of asbestos removal across different environments. Commercial facilities often feature complex HVAC systems and interstitial spaces that require specialized containment strategies compared to residential settings. Our internal quality control process includes multi-point visual inspections and preliminary air sampling to verify site cleanliness. This rigorous approach has made us a trusted partner for government agencies and industrial contractors who can’t afford the risks associated with a failed clearance.

From Abatement to Structural Demolition

Project momentum is critical for large-scale developments. TSIAC International provides a seamless transition from hazardous material mitigation to structural or selective demolition. We specialize in commercial interior gutting services that begin immediately after the final clearance is secured. By acting as a single-source contractor, we reduce project friction and eliminate the scheduling conflicts that typically arise between different trades. The moment the air samples pass, our heavy machinery teams are authorized to proceed, keeping your timeline intact.

Our commitment to safety extends to environmental responsibility. We implement recycling programs on every job site to ensure that non-hazardous materials are diverted from landfills whenever possible. When you partner with TSIAC International, you’re hiring a team that views safety as a precise engineering discipline. We don’t just follow the 2026 protocol; we set the standard for how it’s executed. We handle the technical challenges of what happens if asbestos abatement fails clearance test by ensuring it doesn’t happen on our watch. Our 15-year track record is built on the fact that we solve problems where others see obstacles.

Securing Your Project Site with Professional Remediation

A failed clearance report is a critical milestone that demands immediate technical intervention. When air samples exceed the 0.01 fibers per cubic centimeter threshold established by regulatory bodies, the site must remain sealed until comprehensive recleaning occurs. Navigating what happens if asbestos abatement fails clearance test requires a partner who understands the high stakes of hazardous material management. You’ll need to coordinate with licensed inspectors to identify specific failure points, whether they stem from inadequate HEPA filtration or overlooked settled dust.

TSIAC International leverages 15+ years of industry experience to manage these complex scenarios with engineering precision. We specialize in high-stakes hazardous remediation and offer comprehensive structural demolition capabilities for projects that require a total site reset. Our team ensures every protocol aligns with 2026 safety standards, transforming a failed test into a verified, safe environment. You don’t have to navigate regulatory setbacks alone when expert help is available to restore your project timeline.

Contact TSIAC International for Expert Abatement & Demolition Services

Take the next step toward a certified safe site today.

Frequently Asked Questions

Can I stay in my house if the asbestos clearance test fails?

You cannot stay in the affected area if the asbestos clearance test fails because the containment zone remains a regulated hazard area under OSHA 1926.1101 standards. If the failure occurs in a primary living space, the polyethylene barriers must stay sealed and negative air pressure machines must continue to operate 24 hours a day. Residents shouldn’t re-enter the space until a certified industrial hygienist issues a passing clearance certificate and the containment is officially dismantled.

How many times can an asbestos clearance test fail?

There’s no legal limit on how many times an asbestos clearance test can fail, but repeated failures indicate poor workmanship or inadequate cleaning protocols. Industry data from the Environmental Information Association suggests that 15% of initial clearance tests fail due to residual dust on horizontal surfaces. If a site fails three consecutive times, the project manager must re-evaluate the contractor’s HEPA filtration systems and wet-cleaning techniques to identify the specific source of contamination.

What is the difference between PCM and TEM testing for asbestos?

Phase Contrast Microscopy (PCM) measures total fiber concentration using an optical microscope at 400x magnification, but it can’t distinguish asbestos from organic fibers like cotton or fiberglass. Transmission Electron Microscopy (TEM) uses electron beams at 20,000x magnification to identify the exact mineral structure of asbestos fibers. TEM is 100 times more sensitive than PCM and is required by AHERA standards for schools when the abatement area exceeds 160 square feet of material.

How much does a second asbestos clearance test cost?

A second asbestos clearance test typically costs between $250 and $600 depending on the number of samples required and the laboratory’s turnaround time. According to 2024 national averages, PCM samples cost approximately $50 per slide, while TEM analysis ranges from $150 to $300 per sample. These costs are usually separate from the original abatement contract unless a pass guarantee was explicitly written into the initial service agreement with the contractor.

Who is responsible for cleaning the site after a failed test?

The asbestos abatement contractor is legally and contractually responsible for re-cleaning the site at their own expense after a failed test. Under standard ASTM E2308 protocols, the crew must wet-wipe all surfaces and HEPA vacuum the entire containment area again to remove microscopic debris. This process continues until an independent third-party inspector confirms that the site meets the specific clearance criteria defined in the project’s scope of work.

How long does it take to re-clean a site for a second test?

Re-cleaning a site typically takes between 4 and 24 hours of active labor for a standard 500-square-foot containment area. The process involves a mandatory settling period of 12 hours after the final wipe-down to ensure any airborne particles have landed on surfaces for collection. Once the re-cleaning is finished, the air must be scrubbed for at least 4 full air changes per hour before the hygienist begins the next sampling cycle.

What happens if the visual inspection passes but the air test fails?

If the visual inspection passes but the air test fails, the contractor must perform an additional round of aggressive cleaning because invisible microscopic fibers are still present in the air. This scenario often occurs if what happens if asbestos abatement fails clearance test involves hidden dust in HVAC ducts or porous materials that weren’t properly sealed. The team must re-seal any leaks in the poly sheeting and run HEPA air scrubbers for another 24-hour cycle before re-testing.

Is a failed asbestos test public record?

A failed asbestos clearance test isn’t typically part of the public record for private residential properties, but it must be documented in the project’s permanent logbook for liability reasons. For public schools and government buildings, AHERA regulations require all test results to be kept in the facility’s management plan for 30 years. These records are available for review by parents, employees, and regulatory agencies like the EPA during any scheduled or surprise audit.
